CPU Scheduling
Tom Kelliher, CS 311
Mar. 2, 2012
Announcements:
From last time:
- Processes and threads; context switching.
Outline:
- Traditional process scheduling.
- Comparison criteria.
- Priority functions.
- Thread scheduling.
- Multiprocessor scheduling issues.

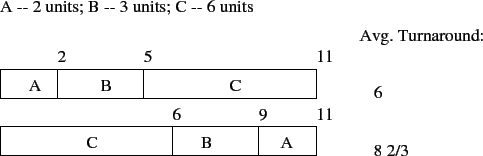

- Gantt chart examples.
Assignment:
Motivation:
- Traditionally: keep the CPU busy.
- Now:
- Promote modular design.
- Increase throughput (a multi-threaded server).
What are the three schedulers, and how do they function?
Model of a process: CPU-I/O burst cycles:
Distribution of bursts.
CPU bursts terminate due to:
- Process waits on event (blocked, suspended).
- Process' quantum expires (back to ready Q).
- Non-Preemptive scheduling.
Context switches occur:
- Running process terminates.
- Running process blocks.
I.e., running process controls the show.
New process takes over if running process blocks.
- Preemptive scheduling.
Principle: Highest priority ready process runs.
Quantum timers come into play.
Additional context switches:
- Higher priority process changes state from blocked to ready,
preempting running process.
- Quantum expires (kernel preempts).
Higher overhead.
- Selective preemptive scheduling.
User oriented, performance related criteria.
- Response time -- time from submission of request to receipt of first
output.
- Turnaround time -- time from submission of request to its
completion.
- Waiting time -- turnaround time minus CPU time; time spent waiting
for resources.
- Deadlines -- When deadlines are specified, percentage of deadlines
which are met.
User oriented, other criteria
- Predictability -- the same job should run in about the same amount
of time and cost regardless of other system activity.
System oriented, performance related criteria
- Throughput -- number of processes completed per unit of time.
- CPU utilization -- percentage of time CPU is performing actual work.
System oriented, other criteria
- Fairness -- processes should generally be treated the same, with no
process starving.
- Priority enforcement -- when priorities are assigned, they should be
adhered to.
- Balancing Resources -- keep all system resources busy, adjust
priorities accordingly. This can come in at the long-term scheduler level.
- CPU time -- usually the most important factor
- memory requirements -- a major criterion in batch systems; in
timesharing systems give a good measure of swapping overhead
- wall time -- important for process ``aging'' -- increase priority
of older jobs.
- total required CPU time -- specify max runtime for job (batch) or
take some average of previous runtimes.
- external priorities -- batch, interactive, realtime, VIP, etc. Let
user pick priority and charge for higher priorities.
- system load -- increasing quantum may offset swapping overhead,
increasing utilization. Continue giving good response to high priority
jobs, making others suffer. Graceful degradation.
Implemented using queues or priority queues.
- FCFS, FIFO -- non-preemptive. Run oldest process. Standard batch
priority function
- Implemented with a simple queue for the ready Q
- New jobs, jobs previously in wait or running state put at end of
ready Q
- Next job to run taken from head of ready Q
- Priority function: time in ready Q
- LIFO -- non-preemptive. Run newest process. Not real useful.
- SJF -- shortest job first. Non-preemptive. Run process with
shortest required CPU time.
- Time is time of next CPU burst.
- Implement with priority Q
- Estimate of next CPU burst:
where
is the estimated time and
is the actual time.
is an exponential average of history.
- Priority function:
Provably optimal from turnaround/waiting point of view:
- SRT -- (shortest remaining time) preemptive version of SJF.
- RR -- (round robin) preemptive FCFS with a time quantum limitation.
Used in time sharing systems.
- Uses FCFS's priority function
- Additional factor in decision epoch: expiration of quantum timer
- Multi-level queues -- prioritized set of queues,
to
.
- Processes in queue
always have priority over queues
.
- A process remains within the same queue.
- Each queue may have its own scheduling algorithm.
- Alternative: each queue gets some fixed slice of the total CPU
cycles.
- Example: Queue for interactive jobs, RR scheduling; queue for
batch jobs, FCFS.
- Multi-level feedback queues -- similar to multi-level queues, except
that a process can move between different queues, based upon CPU usage.
- Must specify rules for moving the processes between queues.
- Ordinarily, lower priority queues have greater quantums, etc.
- Linux uses this method, with a 100ms quantum for all
queues. 141 priorities and run queues. A limited amount of dynamicism
for non-realtime tasks. Higher priority tasks have longer quanta, but
get ``expired,'' preventing starvation.
Suppose the following jobs arrive for processing at the times indicated and
run with the specified CPU bursts (at the end of a burst a process waits
for one time unit on a resource). Assume that a just-created job enters
the ready queue after any job entering the ready queue from the wait queue.
| Job |
Arrival Time |
CPU Bursts |
| 1 |
0 |
1 2 |
| 2 |
1 |
1 3 |
| 3 |
2 |
1 1 |
Calculate the average turnaround time for each of the scheduling
disciplines listed:
- First Come First Served.
- Shortest Remaining Time (assume that the running time
is the sum of the CPU bursts).
- Round robin with a quantum of 1.
Don't forget the ``bubble'' cycles (where no process is runnable), if
required.
Kernel-level (system scope) vs. user-level (process scope) threads.
pthread possibilities (implementation dependent):
- Quantum allocation.
- Process scope thread priorities; starvation.
- Process scope threads with same priority: FIFO (no preemption) or RR
(preemption) algorithms available.
- Symmetric Multiprocessing vs. asymmetric multiprocessing:
or
run queues.
- Processor affinity: maximize cache hit rates vs. load balancing
vs. specialized devices attached to a single CPU.
- Hyperthreading to reduce memory stall-forced CPU idling.
- Virtualization: When a process quantum on a guest OS isn't all it's
cracked up to be.
